Sandy Creek, Concordia and Gawler East: various locations
Upgrading our water network in Sandy Creek, Concordia and Gawler East
To secure reliable water services for existing and future customers in the broader Barossa region, including in Concordia, Gawler East and Roseworthy, we're delivering a program of water infrastructure upgrades across the area.
The planned upgrades include:
- approximately 3,011 metres of new water mains along Martin Road, Concordia, and Sunnydale Avenue and Concordia Road, Gawler East (completed in 2026)

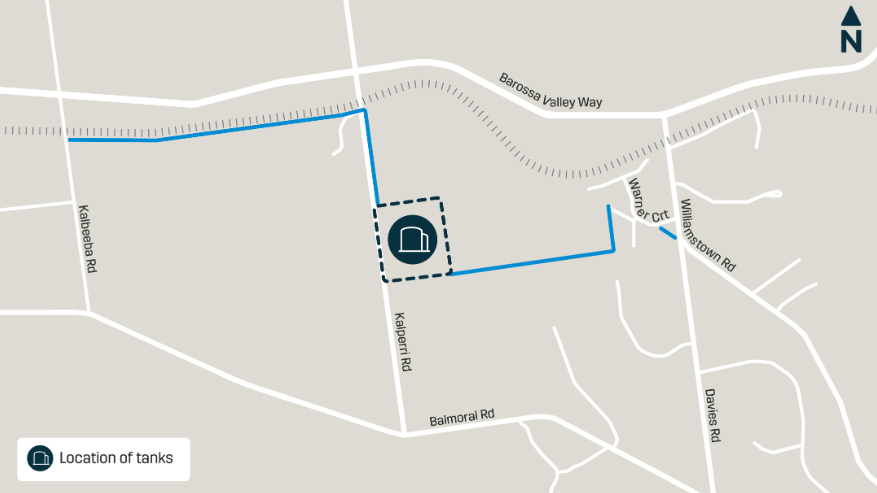

- Four new 10 million litre water storage tanks at Kalperri Road, Sandy Creek
- Tanks 1 & 2 will support broader Barossa network (underway)
- Tanks 3 & 4 will service Concordia (upcoming)
- New water mains on private land, Sandy Creek (underway until late 2026)
- Upgraded booster pump station at the corner of Concordia Road and Barossa Valley Way, Gawler East (underway - November 2025 to early 2027)

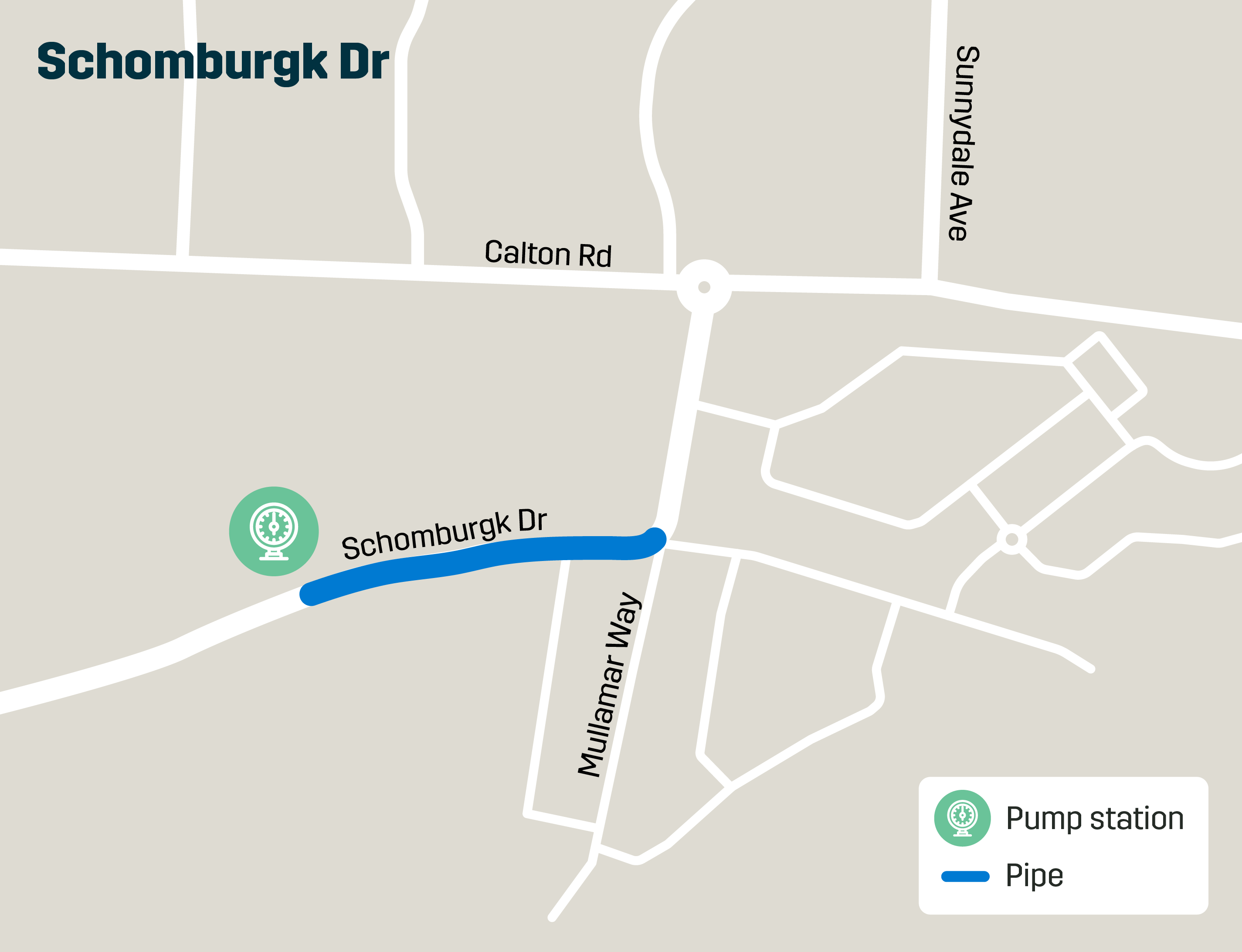

- New booster pump station at Schomburgk Drive (underway).
Sandy Creek tanks and associated water mains
Gawler East and Springwood booster pump stations and associated water mains
We will aim to complete these works as efficiently as possible, minimising disruption to the community.
What to expect
- changed traffic arrangements will be in place across the area until mid-2026
- work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
- you may notice some noise, vibration and dust during construction
- we’ll continue working closely with the community to minimise impacts wherever possible.
Please note: Timeline dates are subject to change based on program requirements and weather conditions.
What happens to roads and footpaths after our works?
We work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.
Find out more about reinstatement
Nearby works
As part of this major upgrade, other nearby works are also happening on:
Go back to the project home page
Need more information?
Visit our FAQs page for answers to the most asked questions.
Upgrading our water network in Sandy Creek, Concordia and Gawler East
To secure reliable water services for existing and future customers in the broader Barossa region, including in Concordia, Gawler East and Roseworthy, we're delivering a program of water infrastructure upgrades across the area.
The planned upgrades include:
- approximately 3,011 metres of new water mains along Martin Road, Concordia, and Sunnydale Avenue and Concordia Road, Gawler East (completed in 2026)
- Four new 10 million litre water storage tanks at Kalperri Road, Sandy Creek
- Tanks 1 & 2 will support broader Barossa network (underway)
- Tanks 3 & 4 will service Concordia (upcoming)
- New water mains on private land, Sandy Creek (underway until late 2026)
- Upgraded booster pump station at the corner of Concordia Road and Barossa Valley Way, Gawler East (underway - November 2025 to early 2027)
- New booster pump station at Schomburgk Drive (underway).
Sandy Creek tanks and associated water mains
Gawler East and Springwood booster pump stations and associated water mains
We will aim to complete these works as efficiently as possible, minimising disruption to the community.
What to expect
- changed traffic arrangements will be in place across the area until mid-2026
- work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
- you may notice some noise, vibration and dust during construction
- we’ll continue working closely with the community to minimise impacts wherever possible.
Please note: Timeline dates are subject to change based on program requirements and weather conditions.
What happens to roads and footpaths after our works?
We work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.
Find out more about reinstatement
Nearby works
As part of this major upgrade, other nearby works are also happening on:
Go back to the project home page
Need more information?
Visit our FAQs page for answers to the most asked questions.
-
Sandy Creek - Night works to support commissioning of the new pipeline
Share Sandy Creek - Night works to support commissioning of the new pipeline on Facebook Share Sandy Creek - Night works to support commissioning of the new pipeline on X (formerly Twitter) Share Sandy Creek - Night works to support commissioning of the new pipeline on Linkedin Email Sandy Creek - Night works to support commissioning of the new pipeline linkThe commissioning works for the Sandy Creek tanks and related infrastructure are currently underway. As part of the commissioning process, the new pipeline will need to be connected to the existing network. To complete this connection and commissioning works as efficiently as possible, crews will be required to work 24/7 for the below dates. Learn more about the commissioning process.
Due to recent weather conditions the connection and commissioning works have been delayed by a week. Our crews will be required to work two nights on the new below dates.
When: Tuesday, 25 August and Tuesday, 1 September 2026
Where: Kalperri to Kalbeeba Pipeline, Sandy Creek
Hours of work:
- Night works: 6:00 pm to 7:00 am
- Existing daytime construction hours will continue
During this time there may be potential temporary impacts to water pressure and quality in the surrounding area. Your water will remain safe to drink, and we recommend running your outside taps for a couple of minutes to help it clear.
As part of these works SA Water will be conducting our second stage of water discharge into the Sandy Creek natural creek bed. SA Water and our contract partner MCDRSRGJV will monitor and observe Sandy Creek during this time to monitor the flow behaviour.
Thank you for your patience while we complete this essential work.
The commissioning works for the Sandy Creek tanks and related infrastructure are currently underway. As part of the commissioning process, the new pipeline will need to be connected to the existing network. To complete this connection and commissioning works as efficiently as possible, crews will be required to work 24/7 for the below dates. Learn more about the commissioning process.
Due to recent weather conditions the connection and commissioning works have been delayed by a week. Our crews will be required to work two nights on the new below dates.
When: Tuesday, 25 August and Tuesday, 1 September 2026
Where: Kalperri to Kalbeeba Pipeline, Sandy Creek
Hours of work:
- Night works: 6:00 pm to 7:00 am
- Existing daytime construction hours will continue
During this time there may be potential temporary impacts to water pressure and quality in the surrounding area. Your water will remain safe to drink, and we recommend running your outside taps for a couple of minutes to help it clear.
As part of these works SA Water will be conducting our second stage of water discharge into the Sandy Creek natural creek bed. SA Water and our contract partner MCDRSRGJV will monitor and observe Sandy Creek during this time to monitor the flow behaviour.
Thank you for your patience while we complete this essential work.
-
Preparing to turn on tanks - various works
Share Preparing to turn on tanks - various works on Facebook Share Preparing to turn on tanks - various works on X (formerly Twitter) Share Preparing to turn on tanks - various works on Linkedin Email Preparing to turn on tanks - various works linkBetween June through to October, we will be preparing to bring new tanks and supporting infrastructure at the Sandy Creek site online and connect to the existing network.
What to expect
- water being released into the Sandy Creek natural creek bed, entering via council swales off Kalperri Road and flowing through nearby properties
- temporary fencing and equipment set up at various points around the site
- some works will occur 24/7, including overnight
- planned network outages with advance notice provided to impacted customers.
- potential temporary impacts to water pressure and quality
Discharging schedule is subject to change dependent on the weather. Large rain events may delay or decrease the volume rate of discharge.
Between June through to October, we will be preparing to bring new tanks and supporting infrastructure at the Sandy Creek site online and connect to the existing network.
What to expect
- water being released into the Sandy Creek natural creek bed, entering via council swales off Kalperri Road and flowing through nearby properties
- temporary fencing and equipment set up at various points around the site
- some works will occur 24/7, including overnight
- planned network outages with advance notice provided to impacted customers.
- potential temporary impacts to water pressure and quality
Discharging schedule is subject to change dependent on the weather. Large rain events may delay or decrease the volume rate of discharge.
-

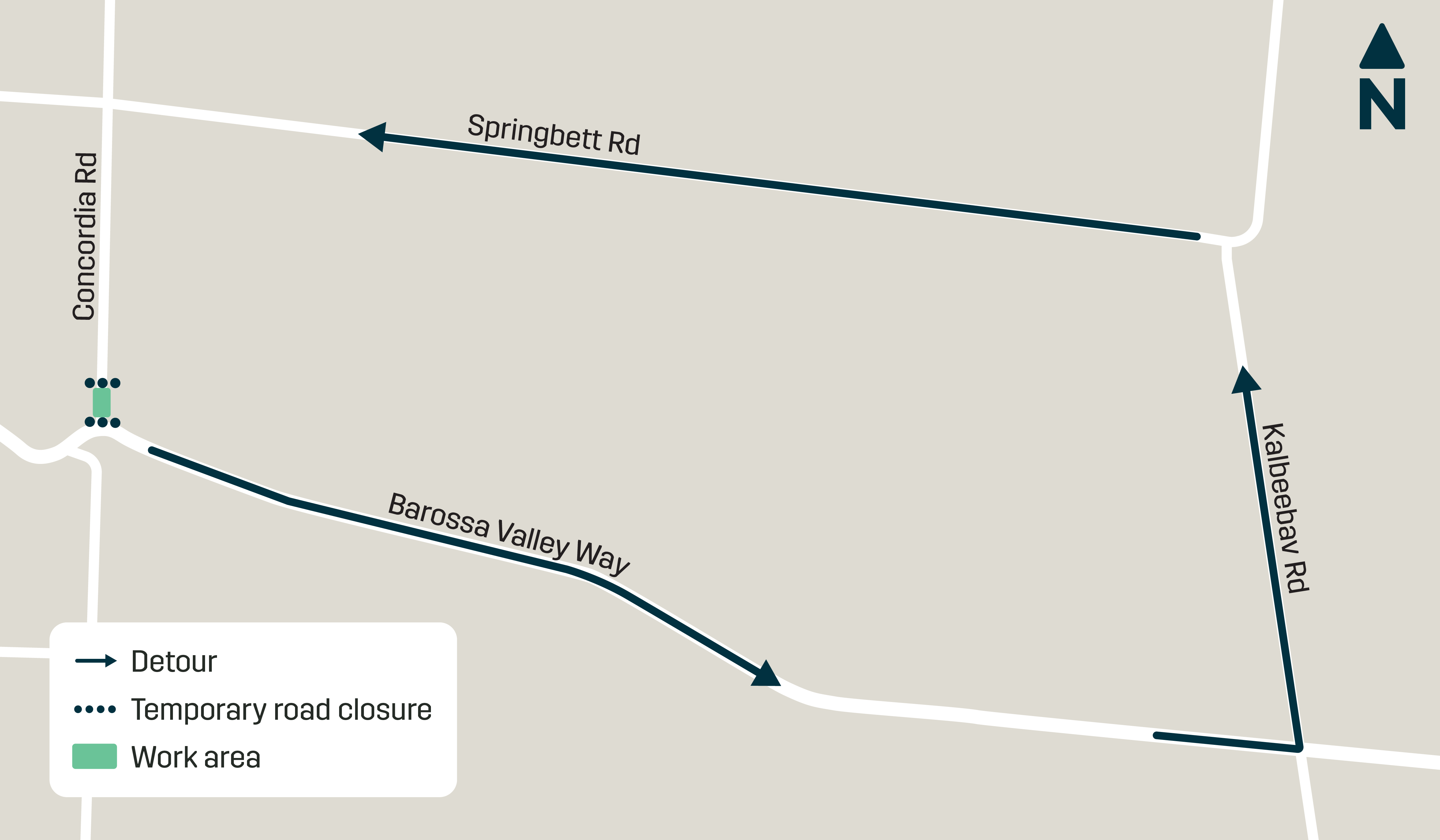

Traffic changes - Concordia Road between Barossa Valley Way and Springbett Road, Concordia
Share Traffic changes - Concordia Road between Barossa Valley Way and Springbett Road, Concordia on Facebook Share Traffic changes - Concordia Road between Barossa Valley Way and Springbett Road, Concordia on X (formerly Twitter) Share Traffic changes - Concordia Road between Barossa Valley Way and Springbett Road, Concordia on Linkedin Email Traffic changes - Concordia Road between Barossa Valley Way and Springbett Road, Concordia linkWhen: 20 July to mid-September
Where: Concordia Road between Barossa Valley Way and Springbett Road, Concordia
Hours of work: 7:00am – 6:00pm, Monday to Saturday (road closures in place 24/7)
Key details
- we are installing pipework associated with the new pump station
- we will be discharging water in the area during commissioning of pipework
- detours will be in place, please follow signage onsite and observe bridge weight rating
- local access will be maintained at all times.

Please note: Timeline dates are subject to change based on program requirements and weather conditions.
We appreciate your patience as we complete this important work.
When: 20 July to mid-September
Where: Concordia Road between Barossa Valley Way and Springbett Road, Concordia
Hours of work: 7:00am – 6:00pm, Monday to Saturday (road closures in place 24/7)
Key details
- we are installing pipework associated with the new pump station
- we will be discharging water in the area during commissioning of pipework
- detours will be in place, please follow signage onsite and observe bridge weight rating
- local access will be maintained at all times.

Please note: Timeline dates are subject to change based on program requirements and weather conditions.
We appreciate your patience as we complete this important work.
-

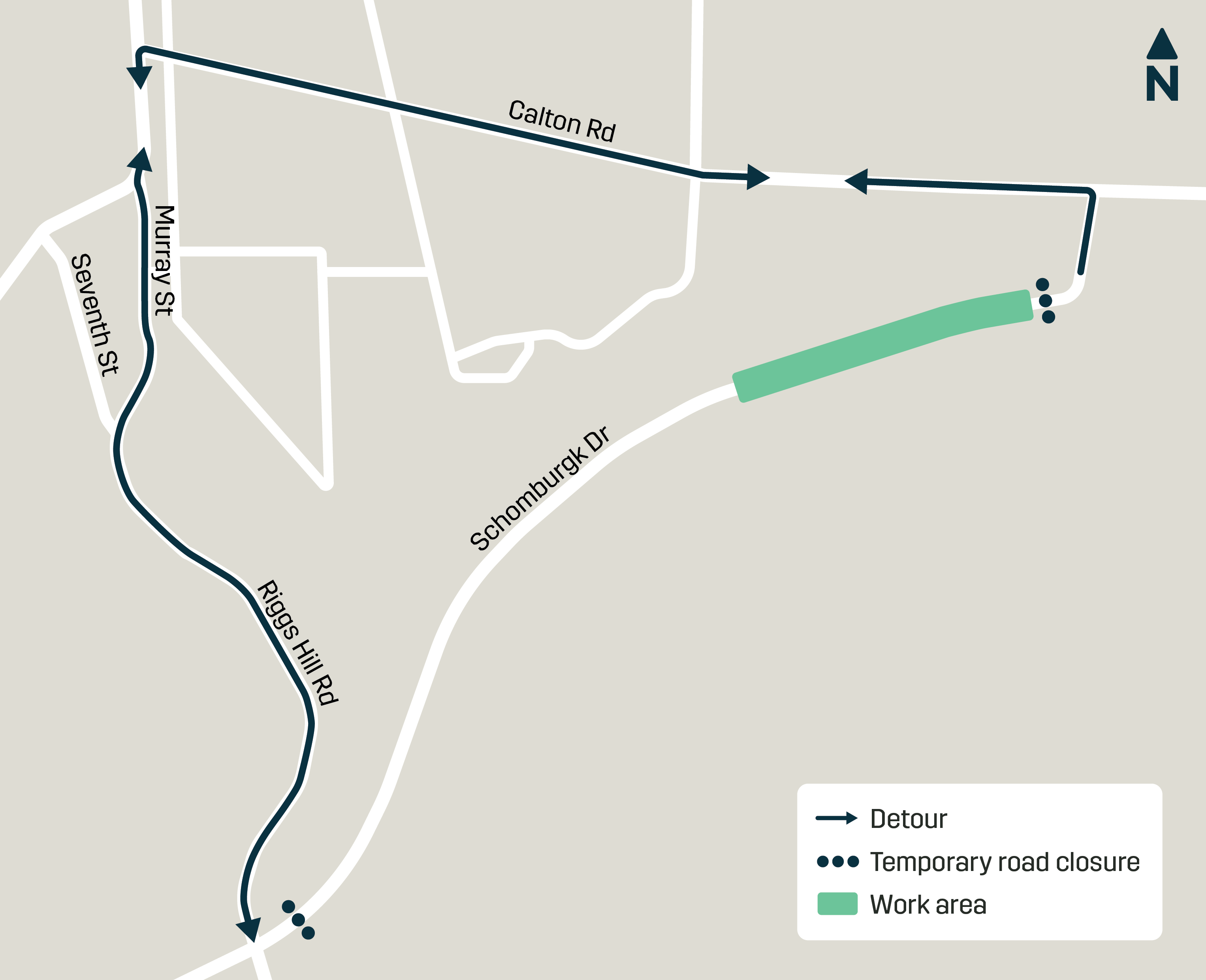

Day works – corner of Concordia Road and Barossa Valley Way
Share Day works – corner of Concordia Road and Barossa Valley Way on Facebook Share Day works – corner of Concordia Road and Barossa Valley Way on X (formerly Twitter) Share Day works – corner of Concordia Road and Barossa Valley Way on Linkedin Email Day works – corner of Concordia Road and Barossa Valley Way linkFrom November 2025, we’ll be upgrading the local water infrastructure along Concordia Road. This includes replacing the existing booster pump station located at the corner of Concordia Road and Barossa Valley Way.
To support these major network upgrades, a site compound will be established at the junction of Concordia Road and Barossa Valley Way, Gawler East. The compound will include offices, staff amenities, carparking and storage areas for machinery and construction materials. It will be set up with our contractors, John Holland Guidera O’Connor Joint Venture, from late November 2025.
Construction of the new booster pump station will begin in late November 2025 and continue through to mid-2027.
We’ll aim to complete these works as efficiently as possible, minimising disruption to the community.
When: Late November 2025 – mid-2027Where: Corner of Concordia Road and Barossa Valley Way
Hours of work: 7:00am – 5:00pm, Monday to Saturday
Please note: Timeline dates are subject to change based on program requirements and weather conditions. In the event of extreme heat, our crews may begin work one hour earlier, commencing at 6:00am.
Thank you for your patience while we complete these essential works.
From November 2025, we’ll be upgrading the local water infrastructure along Concordia Road. This includes replacing the existing booster pump station located at the corner of Concordia Road and Barossa Valley Way.
To support these major network upgrades, a site compound will be established at the junction of Concordia Road and Barossa Valley Way, Gawler East. The compound will include offices, staff amenities, carparking and storage areas for machinery and construction materials. It will be set up with our contractors, John Holland Guidera O’Connor Joint Venture, from late November 2025.
Construction of the new booster pump station will begin in late November 2025 and continue through to mid-2027.
We’ll aim to complete these works as efficiently as possible, minimising disruption to the community.
When: Late November 2025 – mid-2027Where: Corner of Concordia Road and Barossa Valley Way
Hours of work: 7:00am – 5:00pm, Monday to Saturday
Please note: Timeline dates are subject to change based on program requirements and weather conditions. In the event of extreme heat, our crews may begin work one hour earlier, commencing at 6:00am.
Thank you for your patience while we complete these essential works.
-
Stay informed and have your say
Share Stay informed and have your say on Facebook Share Stay informed and have your say on X (formerly Twitter) Share Stay informed and have your say on Linkedin Email Stay informed and have your say linkAs we upgrade our water and wastewater networks, we’d love to hear from you. Your feedback helps us understand what’s working well and where we can improve. Visit this link to have your say.
Read our Community Newsletter for updates on works happening near you, how we’re working to minimise disruptions, and ways to stay informed.
As we upgrade our water and wastewater networks, we’d love to hear from you. Your feedback helps us understand what’s working well and where we can improve. Visit this link to have your say.
Read our Community Newsletter for updates on works happening near you, how we’re working to minimise disruptions, and ways to stay informed.
-
October–November 2024
Sandy Creek, Concordia and Gawler East: various locations has finished this stageSandy Creek tanks 1 & 2 aesthetics engagement. Community invited to share feedback on aesthetics of the tank site to inform site design.
-
December 2024
Sandy Creek, Concordia and Gawler East: various locations has finished this stageSite preparation, Martin Road.
-
January 2025
Sandy Creek, Concordia and Gawler East: various locations has finished this stagePipeline installation begins, Martin Road.
-
Late-March 2025
Sandy Creek, Concordia and Gawler East: various locations has finished this stageEarthworks commence at Kalperri Road, Sandy Creek tank site for tanks 1 & 2.
-
June–July 2025
Sandy Creek, Concordia and Gawler East: various locations has finished this stagePipeline installation occurs at Sunnydale Avenue.
-
Mid-2025 – mid-2026
Sandy Creek, Concordia and Gawler East: various locations has finished this stageSandy Creek tanks 1 & 2 construction occurs.
-
November 2025
Sandy Creek, Concordia and Gawler East: various locations has finished this stageMartin Road reinstatement occurs.
-
January 2026
Sandy Creek, Concordia and Gawler East: various locations has finished this stageGawler East booster pump station construction commences.
-
April–June 2026
Sandy Creek, Concordia and Gawler East: various locations has finished this stageSunnydale Avenue tie-in and final reinstatement occurs.
-
June–late 2026
Sandy Creek, Concordia and Gawler East: various locations is currently at this stageSandy Creek tanks 1 & 2 commissioning occurs.
-
September 2026
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsSpringwood booster pump station works commence, Schomburgk Drive.
-
Late 2026
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsEarthworks commence at Kalperri Road, Sandy Creek tank site for tanks 3 & 4.
-
Late-2026
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsGawler East booster pump station completion.
-
February 2027
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsSpringwood booster pump station completion.
-
2027-2028
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsSandy Creek tanks 3 & 4 construction occurs.
-
April 2027
this is an upcoming stage for Sandy Creek, Concordia and Gawler East: various locationsRemoval of original Gawler East booster pump station.
-
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Community and Stakeholder Engagement Manager
McConnell Dowell SRG Global Joint Venture (MCDSRGJV)
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Communications and Stakeholder Engagement Adviser
McConnell Dowell SRG Global Joint Venture (MCDSRGJV)
Phone 1300 981 233 Email metrogrowth@sawater.com.au
Deaf, hearing or speech impaired customers.
Contact us through the National Relay Service and ask for SA Water on 1300 981 233.
- TTY users phone 133 677 then ask for SA Water on 1300 981 233
- Speak and Listen users phone 1300 555 727 then ask for SA Water on 1300 981 233

Calling from overseas
You can contact us on +61 8 7424 1735
-
Metro Growth Community Newsletter August 2026 (2.64 MB) (pdf)
-
Metro Growth Community Newsletter June 2026 (1.16 MB) (pdf)
-
Metro Growth Community Newsletter April 2026 (1.11 MB) (pdf)
-
Metro Growth Community Newsletter February 2026 .pdf (2.4 MB) (pdf)
-
Metro Growth Community Newsletter December 2025.pdf (1.44 MB) (pdf)
-
Metro Growth Community Newsletter October 2025 (1.81 MB) (pdf)
-
Metro Growth Community Newsletter August 2025 .pdf (5 MB) (pdf)
-
Metro Growth Community Newsletter June 2025.pdf (2.36 MB) (pdf)
-
Metro Growth Community Newsletter May 2025 (2.01 MB) (pdf)
-
Metro Growth Community Newsletter April 2025 (2.01 MB) (pdf)
-
Metro Growth Community Newsletter March 2025 (1.41 MB) (pdf)
