Buckland Park: Brooks Road

Share Buckland Park: Brooks Road on Facebook Share Buckland Park: Brooks Road on X (formerly Twitter) Share Buckland Park: Brooks Road on Linkedin Email Buckland Park: Brooks Road link

Upgrading our wastewater network in Buckland Park

To support reliable wastewater services for existing and future customers in Riverlea, we’re installing approximately 7,000 metres of new wastewater mains in Buckland Park.

The upgrade will include connecting new pipes directly to the Bolivar wastewater treatment plant and installing a pump station on Brooks Road.

This upgrade is an important part of strengthening the network and supporting growth in the area.

Where we’re working

Wastewater pipe installation works will take place along or across the following locations:

What to expect

  • changed traffic arrangements will be in place throughout the area until the end of 2026
  • work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
  • you may notice some noise, vibration and dust during construction
  • we will continue to work closely with the community to minimise impacts wherever possible
  • if you're directly affected, we will provide advance notice and work closely with residents, businesses and road users before and during construction.

Please note: Timeline dates are subject to change based on program requirements and weather conditions.

What happens to roads and footpaths after our works?

We will work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.

Find out more about reinstatement

Other works
Find out about other works happening as part of these major upgrades - Go back to the project home page

Need more information?

Visit our FAQs page for answers to the most asked questions.

Upgrading our wastewater network in Buckland Park

To support reliable wastewater services for existing and future customers in Riverlea, we’re installing approximately 7,000 metres of new wastewater mains in Buckland Park.

The upgrade will include connecting new pipes directly to the Bolivar wastewater treatment plant and installing a pump station on Brooks Road.

This upgrade is an important part of strengthening the network and supporting growth in the area.

Where we’re working

Wastewater pipe installation works will take place along or across the following locations:

What to expect

  • changed traffic arrangements will be in place throughout the area until the end of 2026
  • work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
  • you may notice some noise, vibration and dust during construction
  • we will continue to work closely with the community to minimise impacts wherever possible
  • if you're directly affected, we will provide advance notice and work closely with residents, businesses and road users before and during construction.

Please note: Timeline dates are subject to change based on program requirements and weather conditions.

What happens to roads and footpaths after our works?

We will work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.

Find out more about reinstatement

Other works
Find out about other works happening as part of these major upgrades - Go back to the project home page

Need more information?

Visit our FAQs page for answers to the most asked questions.

  • Current Traffic Updates for Brooks Road Buckland Park

    Share Current Traffic Updates for Brooks Road Buckland Park on Facebook Share Current Traffic Updates for Brooks Road Buckland Park on X (formerly Twitter) Share Current Traffic Updates for Brooks Road Buckland Park on Linkedin Email Current Traffic Updates for Brooks Road Buckland Park link

    Work on the Brooks Road sewer main installation project is progressing, with the following activities expected to take place over the coming weeks.

    When: Thursday 16 July between 7am – 5pm

    Where: Brooks Road intersections between McEvoy Road, Ryan Road and White Road

    Key details

    • Crews will be cutting bitumen at the following intersections in preparation for trenching and pipelaying crossover activities:
    • Each intersection will take around 3 hours to complete.

    Contraflow traffic control will be in place at each intersection so vehicles can continue to pass through safely while work is underway.



    When: Monday 20 to Tuesday 21 July between 7am – 5pm

    Where: Brooks Road and Ryan Road intersection

    Key details

    • Open trenching and pipe laying at the Ryan Road / Brooks Road intersection will occur on Monday 20 July, with work expected to finish by the end of the day on Tuesday 21 July.
    • Temporary fencing will be installed around the open trench on Monday evening to keep the area safe and secure overnight.

    Contraflow traffic control will be in place to enable vehicles to safely pass through the intersection while work is underway.



    When: Late July 2026 to November 2026

    Where: Brooks Road, between Thompson and McEvoy Roads - Road closure

    Key details

    • The closure of this section is planned for late July until November.
    • Traffic will detour via McEvoy, Tozer and Thompson Roads during these works.

    This is expected to be the longest closure required for the project.



    When: Ongoing until 24 July 2026

    Where: Brooks Road between McEvoy and Ryan Road - Road Closure

    Key details

    • Crew continue to work southward between McEvoy and Ryan Roads, with traffic detouring via Ryan, Tozer and McEvoy Roads.
    • Work in this section is expected to be completed by 24 July, with the road reopened to through traffic soon after.



    When: Ongoing until 21 August 2026

    Where: Brooks Road between Ryan and White Road - Road Closure

    Key details

    • Crew continue to work between Ryan Road and White Road with closures established in sections as required.
    • Traffic for this section will detour via White, Tozer and Ryan Roads. Residents will have access to their properties either via Ryan or White Rd, depending on the work zone.
    • This work is expected to take approximately 5 weeks, subject to weather and ground conditions


    We apologise for the inconvenience and thank you for your patience while these essential works are completed.

    Work on the Brooks Road sewer main installation project is progressing, with the following activities expected to take place over the coming weeks.

    When: Thursday 16 July between 7am – 5pm

    Where: Brooks Road intersections between McEvoy Road, Ryan Road and White Road

    Key details

    • Crews will be cutting bitumen at the following intersections in preparation for trenching and pipelaying crossover activities:
    • Each intersection will take around 3 hours to complete.

    Contraflow traffic control will be in place at each intersection so vehicles can continue to pass through safely while work is underway.



    When: Monday 20 to Tuesday 21 July between 7am – 5pm

    Where: Brooks Road and Ryan Road intersection

    Key details

    • Open trenching and pipe laying at the Ryan Road / Brooks Road intersection will occur on Monday 20 July, with work expected to finish by the end of the day on Tuesday 21 July.
    • Temporary fencing will be installed around the open trench on Monday evening to keep the area safe and secure overnight.

    Contraflow traffic control will be in place to enable vehicles to safely pass through the intersection while work is underway.

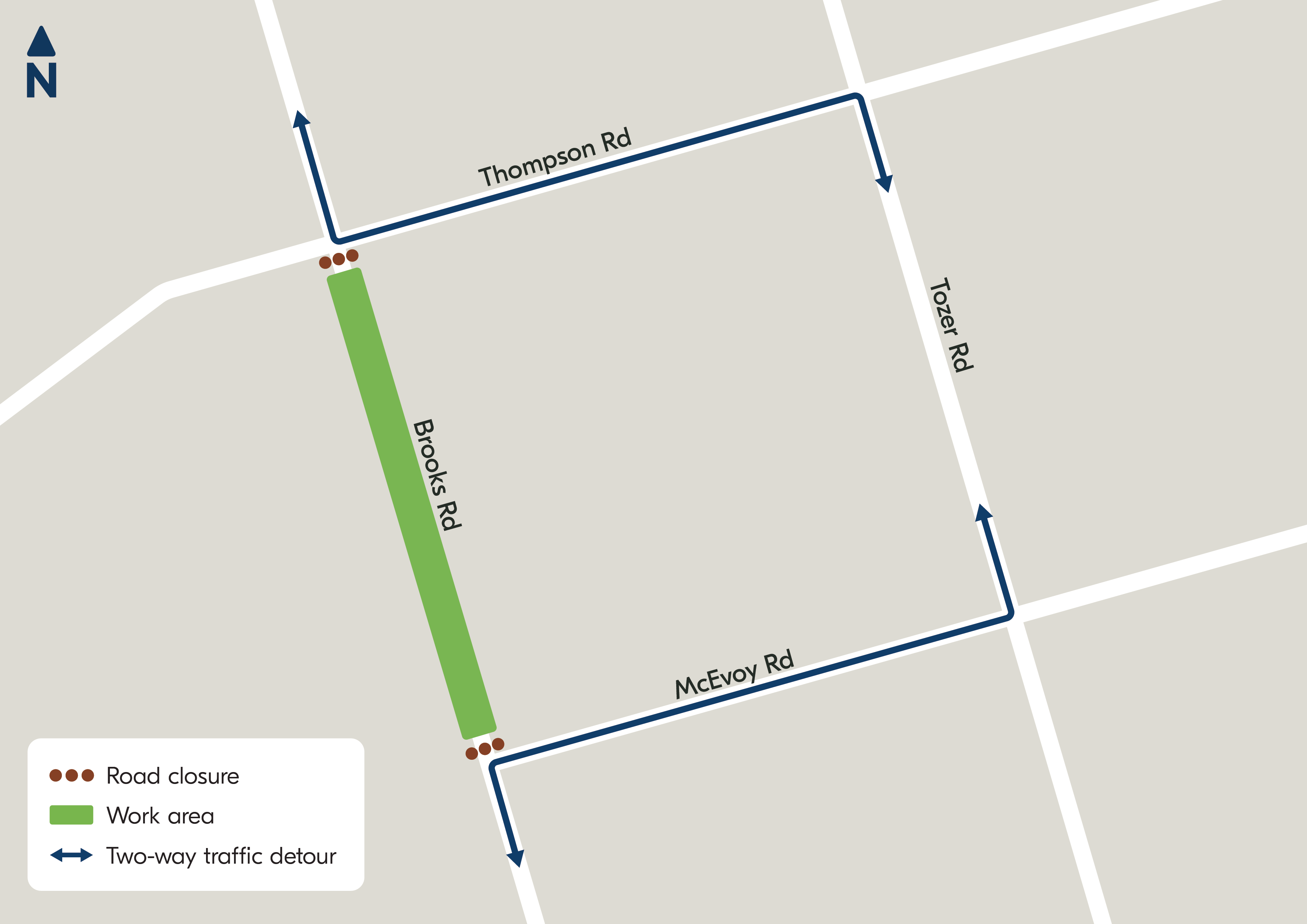

    When: Late July 2026 to November 2026

    Where: Brooks Road, between Thompson and McEvoy Roads - Road closure

    Key details

    • The closure of this section is planned for late July until November.
    • Traffic will detour via McEvoy, Tozer and Thompson Roads during these works.

    This is expected to be the longest closure required for the project.

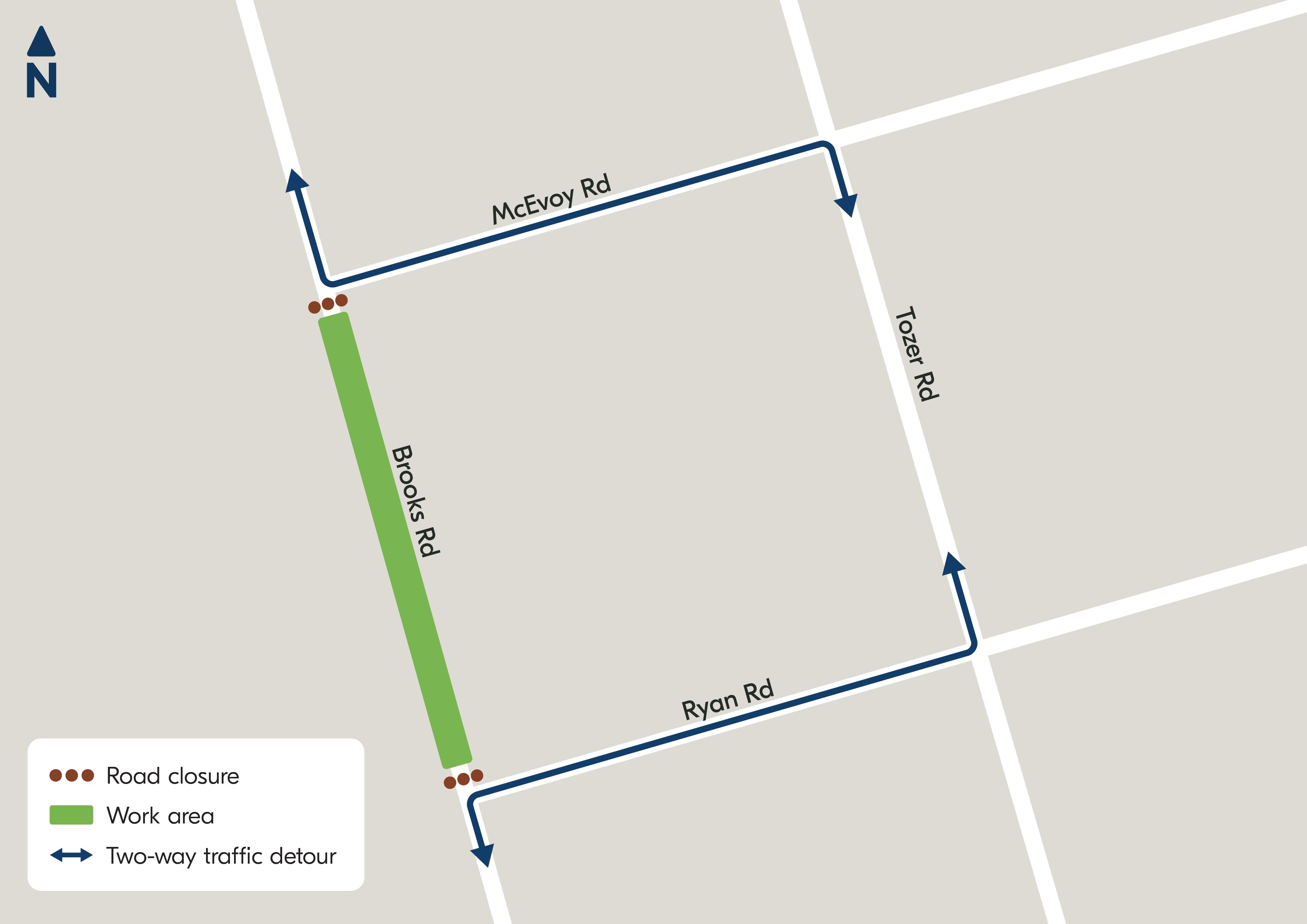

    When: Ongoing until 24 July 2026

    Where: Brooks Road between McEvoy and Ryan Road - Road Closure

    Key details

    • Crew continue to work southward between McEvoy and Ryan Roads, with traffic detouring via Ryan, Tozer and McEvoy Roads.
    • Work in this section is expected to be completed by 24 July, with the road reopened to through traffic soon after.

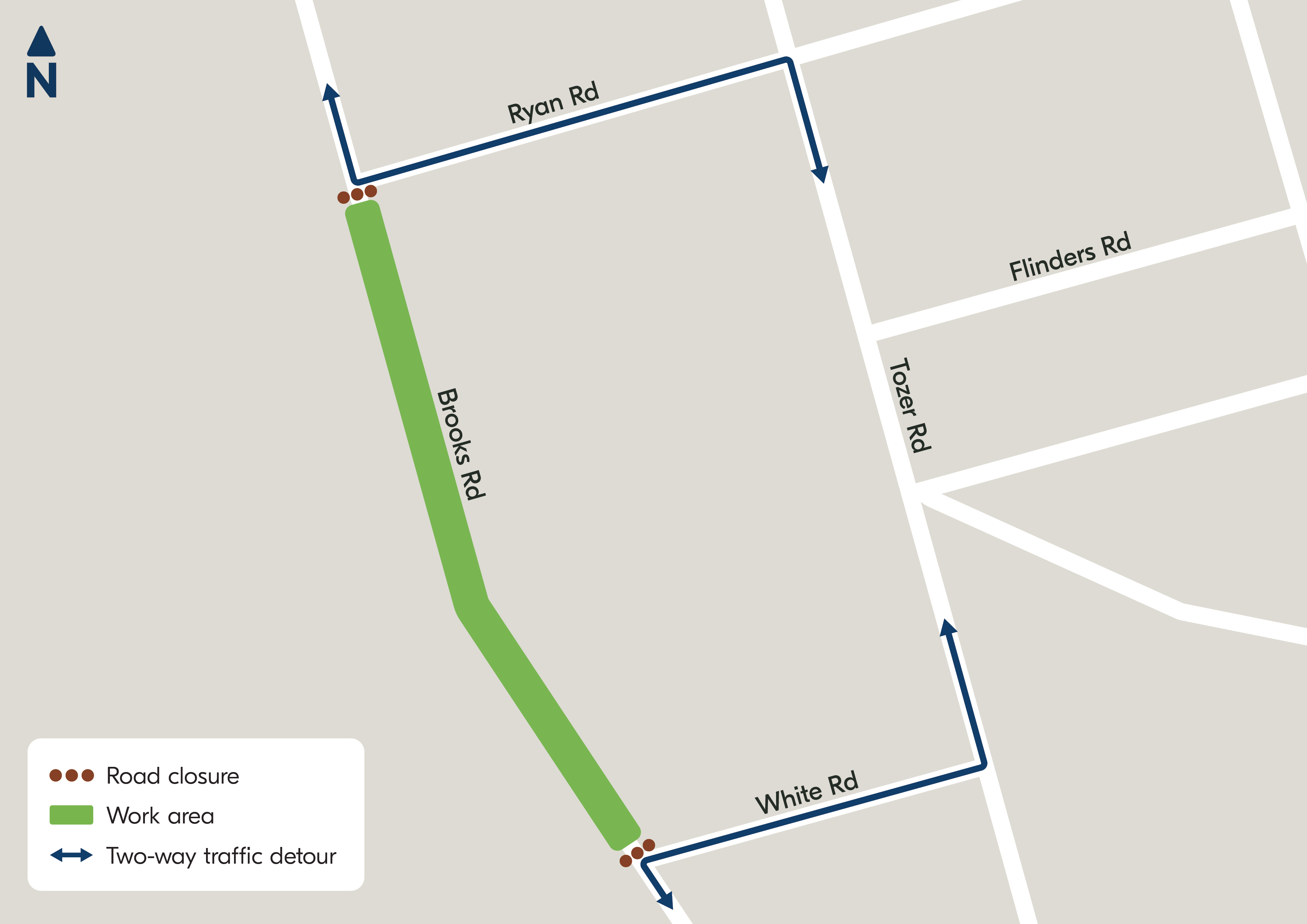

    When: Ongoing until 21 August 2026

    Where: Brooks Road between Ryan and White Road - Road Closure

    Key details

    • Crew continue to work between Ryan Road and White Road with closures established in sections as required.
    • Traffic for this section will detour via White, Tozer and Ryan Roads. Residents will have access to their properties either via Ryan or White Rd, depending on the work zone.
    • This work is expected to take approximately 5 weeks, subject to weather and ground conditions


    We apologise for the inconvenience and thank you for your patience while these essential works are completed.
