Angle Vale to Munno Para West: Curtis Road, Heaslip Road
Upgrading our water and wastewater network on Curtis Road, Heaslip Road and surrounds
We’re investing in water and wastewater infrastructure along Curtis Road and Heaslip Road as part of a major network upgrade.
Curtis Road works include installing 2200 metres of wastewater mains between Andrews Road and Heaslip Road. Works are also happening on Curtis Road between Andrews Road and Stebonheath Road.
Heaslip Road works include installing 600 metres of new water and, 2200 metres of new wastewater mains from Curtis Rd moving progressively north.
This essential work is scheduled to begin in mid-march 2026 and to be completed by mid-2027.
This upgrade is an important part of strengthening the network and supporting growth in the area.
Where we’re working
Pipe installation works will take place along or across the following locations:
- Heaslip Road and surrounding streets
- Curtis Road (Angle Vale)
- Across Northern Expressway
- Curtis Road (Munno Para West)

What to expect
- changed traffic arrangements will be in place along Curtis Road, Heaslip Road and surrounding streets until mid-2027
- work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
- you may notice some noise, vibration, and dust during construction
- we will continue to work closely with the community to minimise impacts wherever possible
- if you're directly affected, we’ll provide advance notice and work closely with residents, businesses, and road users before and during construction.
Please note: Timeline dates are subject to change based on program requirements and weather conditions.
What happens to roads and footpaths after our works?
We work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.
Find out more about reinstatement
Nearby Works
As part of this major upgrade, other nearby works are also happening on:
- Blakeview to Munno Para West: Craigmore Road, Curtis Road | SA Water
- Munno Para Downs to Andrews Farm: Andrews Road, Angle Vale Road
Go back to the project home page
Need more information?
Visit our FAQs page for answers to the most asked questions.
Upgrading our water and wastewater network on Curtis Road, Heaslip Road and surrounds
We’re investing in water and wastewater infrastructure along Curtis Road and Heaslip Road as part of a major network upgrade.
Curtis Road works include installing 2200 metres of wastewater mains between Andrews Road and Heaslip Road. Works are also happening on Curtis Road between Andrews Road and Stebonheath Road.
Heaslip Road works include installing 600 metres of new water and, 2200 metres of new wastewater mains from Curtis Rd moving progressively north.
This essential work is scheduled to begin in mid-march 2026 and to be completed by mid-2027.
This upgrade is an important part of strengthening the network and supporting growth in the area.
Where we’re working
Pipe installation works will take place along or across the following locations:
- Heaslip Road and surrounding streets
- Curtis Road (Angle Vale)
- Across Northern Expressway
- Curtis Road (Munno Para West)

What to expect
- changed traffic arrangements will be in place along Curtis Road, Heaslip Road and surrounding streets until mid-2027
- work may take place during the day, at night or on weekends to help maintain schedule and minimise disruption
- you may notice some noise, vibration, and dust during construction
- we will continue to work closely with the community to minimise impacts wherever possible
- if you're directly affected, we’ll provide advance notice and work closely with residents, businesses, and road users before and during construction.
Please note: Timeline dates are subject to change based on program requirements and weather conditions.
What happens to roads and footpaths after our works?
We work closely with the local council and follow all required reinstatement obligations, reinstating the parts of the road, footpath or the environment directly impacted by our works.
Find out more about reinstatement
Nearby Works
As part of this major upgrade, other nearby works are also happening on:
- Blakeview to Munno Para West: Craigmore Road, Curtis Road | SA Water
- Munno Para Downs to Andrews Farm: Andrews Road, Angle Vale Road
Go back to the project home page
Need more information?
Visit our FAQs page for answers to the most asked questions.
-
Night works – Heaslip Road
Share Night works – Heaslip Road on Facebook Share Night works – Heaslip Road on X (formerly Twitter) Share Night works – Heaslip Road on Linkedin Email Night works – Heaslip Road linkMicro tunnelling works to install new wastewater pipes at the Heaslip Road and Virgara Way/Saverio Boulevard roundabout and the Heaslip Road and Angle Vale Road roundabout will commence from 20 September 2026 and continue intermittently until late-October 2026.

When: 20 September until late October 2026Where: Heaslip Road and Virgara Way / Saverio Boulevard roundabout

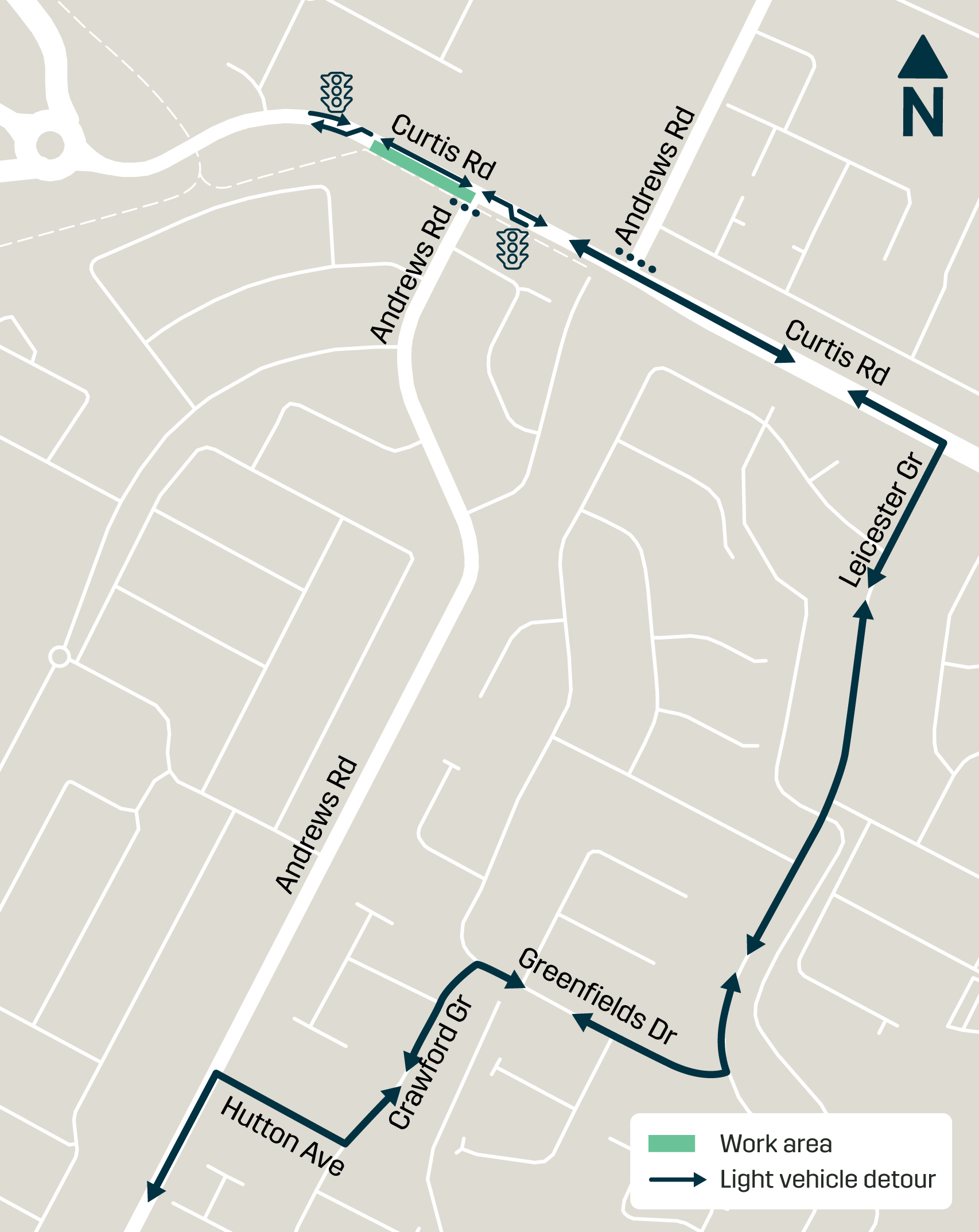

Heaslip Road and Angle Vale Road roundabout
Hours of work: 7:00 pm to 6:00 am Sunday to Thursday
Key details:
night works will occur intermittently at the roundabouts. During works, temporary traffic restrictions will be in place, affecting northbound and southbound travel on Heaslip Road
detours will be in place, please follow signage onsite
changed traffic conditions will apply
some vibration, noise and dust are to be expected during these works
local and business access will be maintained at all times.
Please note, traffic arrangements may change depending on site conditions.Thank you for your patience while we complete these essential works.

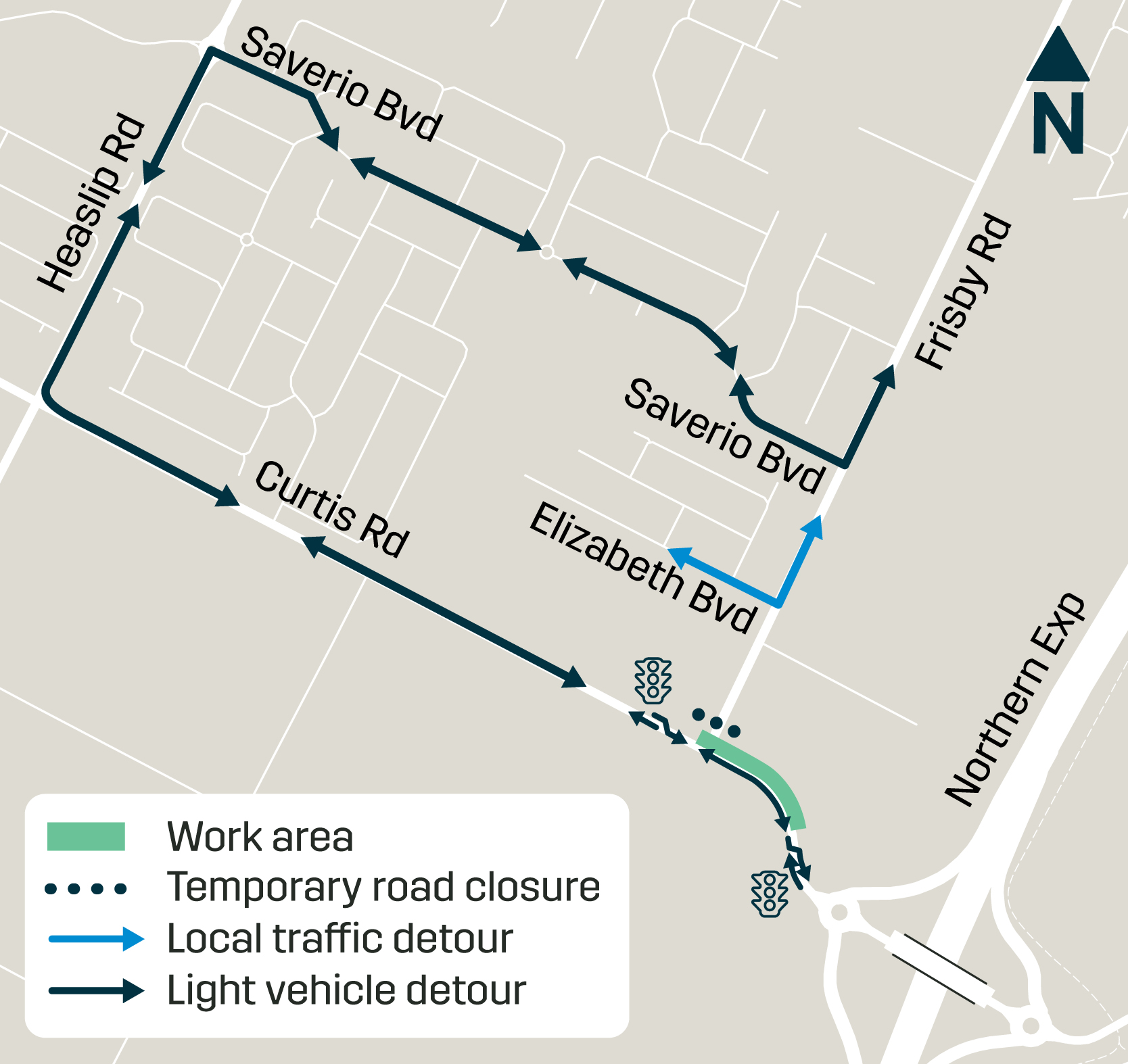

Micro tunnelling works to install new wastewater pipes at the Heaslip Road and Virgara Way/Saverio Boulevard roundabout and the Heaslip Road and Angle Vale Road roundabout will commence from 20 September 2026 and continue intermittently until late-October 2026.
When: 20 September until late October 2026Where: Heaslip Road and Virgara Way / Saverio Boulevard roundabout
Heaslip Road and Angle Vale Road roundabout
Hours of work: 7:00 pm to 6:00 am Sunday to Thursday
Key details:
night works will occur intermittently at the roundabouts. During works, temporary traffic restrictions will be in place, affecting northbound and southbound travel on Heaslip Road
detours will be in place, please follow signage onsite
changed traffic conditions will apply
some vibration, noise and dust are to be expected during these works
local and business access will be maintained at all times.
Please note, traffic arrangements may change depending on site conditions.Thank you for your patience while we complete these essential works.
-
Day works - Ashwin street
Share Day works - Ashwin street on Facebook Share Day works - Ashwin street on X (formerly Twitter) Share Day works - Ashwin street on Linkedin Email Day works - Ashwin street linkWorks to install new wastewater pipes on Ashwin Street, Broster Rd and Luis Drive commenced in early May 2026. Works will move progressively, with additional works to be undertaken on surrounding streets.

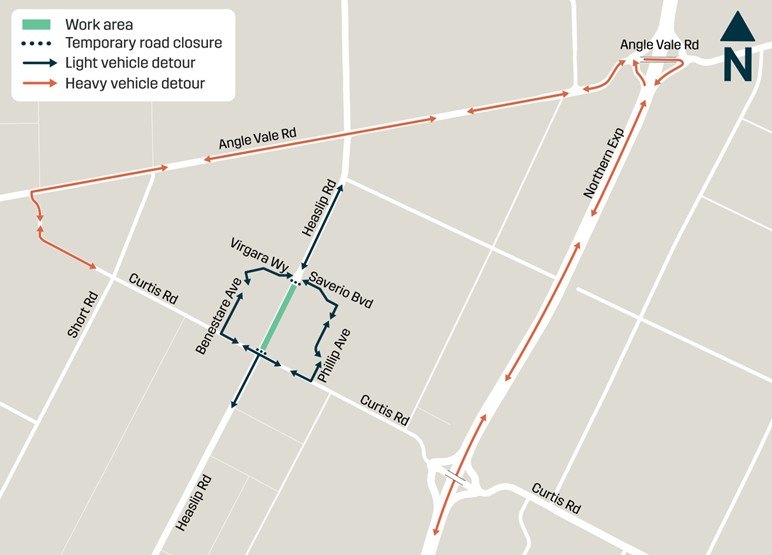

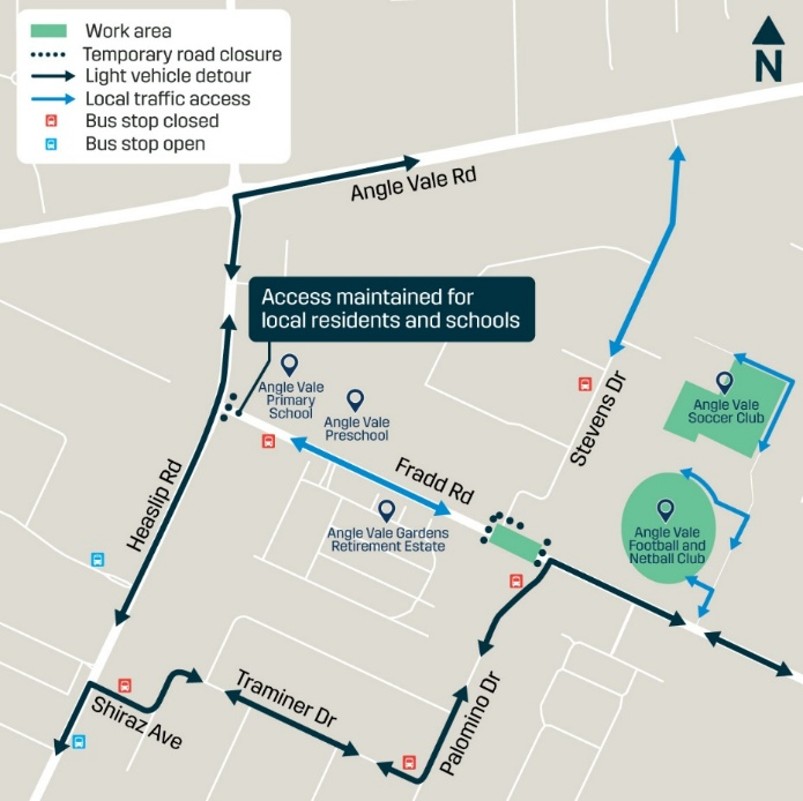

When: early September until early October 2026Where: Ashwin Street, between Natasha Avenue and Dana Street
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:
detours will be in place, please follow signage onsite
changed traffic conditions will apply
some vibration, noise and dust are to be expected during these works
Please note, traffic arrangements may change depending on site conditions
We will restore any impacted roads, footpaths or the environment as soon as it’s safe and practical to do so.
Thank you for your patience while we complete these essential works.
Works to install new wastewater pipes on Ashwin Street, Broster Rd and Luis Drive commenced in early May 2026. Works will move progressively, with additional works to be undertaken on surrounding streets.
When: early September until early October 2026Where: Ashwin Street, between Natasha Avenue and Dana Street
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:
detours will be in place, please follow signage onsite
changed traffic conditions will apply
some vibration, noise and dust are to be expected during these works
Please note, traffic arrangements may change depending on site conditions
We will restore any impacted roads, footpaths or the environment as soon as it’s safe and practical to do so.
Thank you for your patience while we complete these essential works.
-

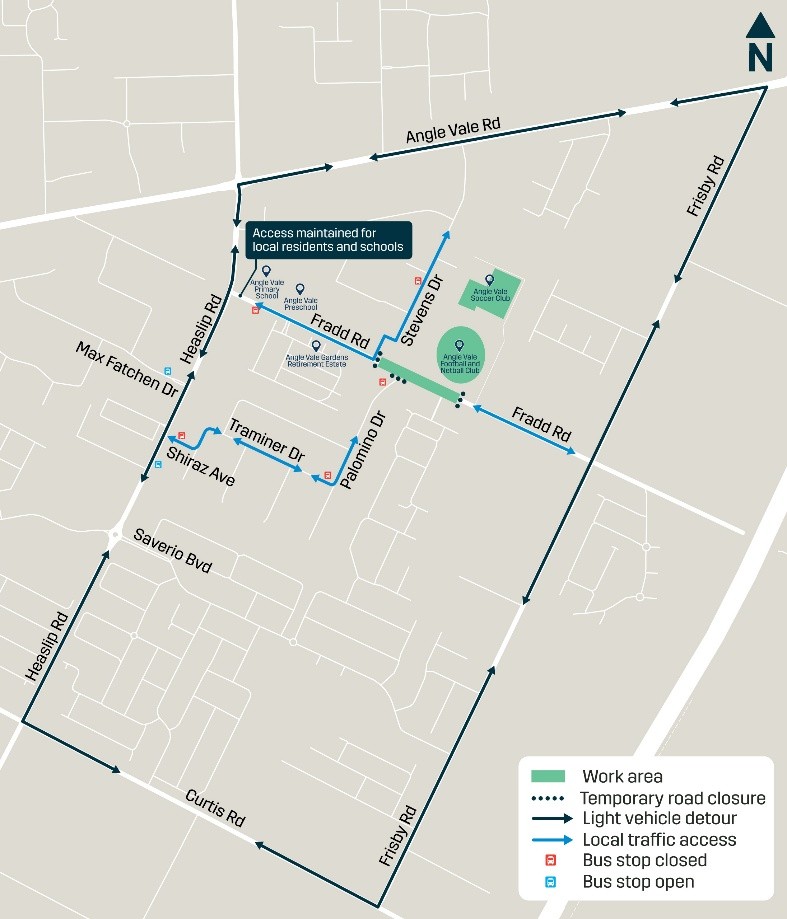

Road closure Heaslip Rd, Angle Vale
Share Road closure Heaslip Rd, Angle Vale on Facebook Share Road closure Heaslip Rd, Angle Vale on X (formerly Twitter) Share Road closure Heaslip Rd, Angle Vale on Linkedin Email Road closure Heaslip Rd, Angle Vale linkWhen: 14 September until late 2026

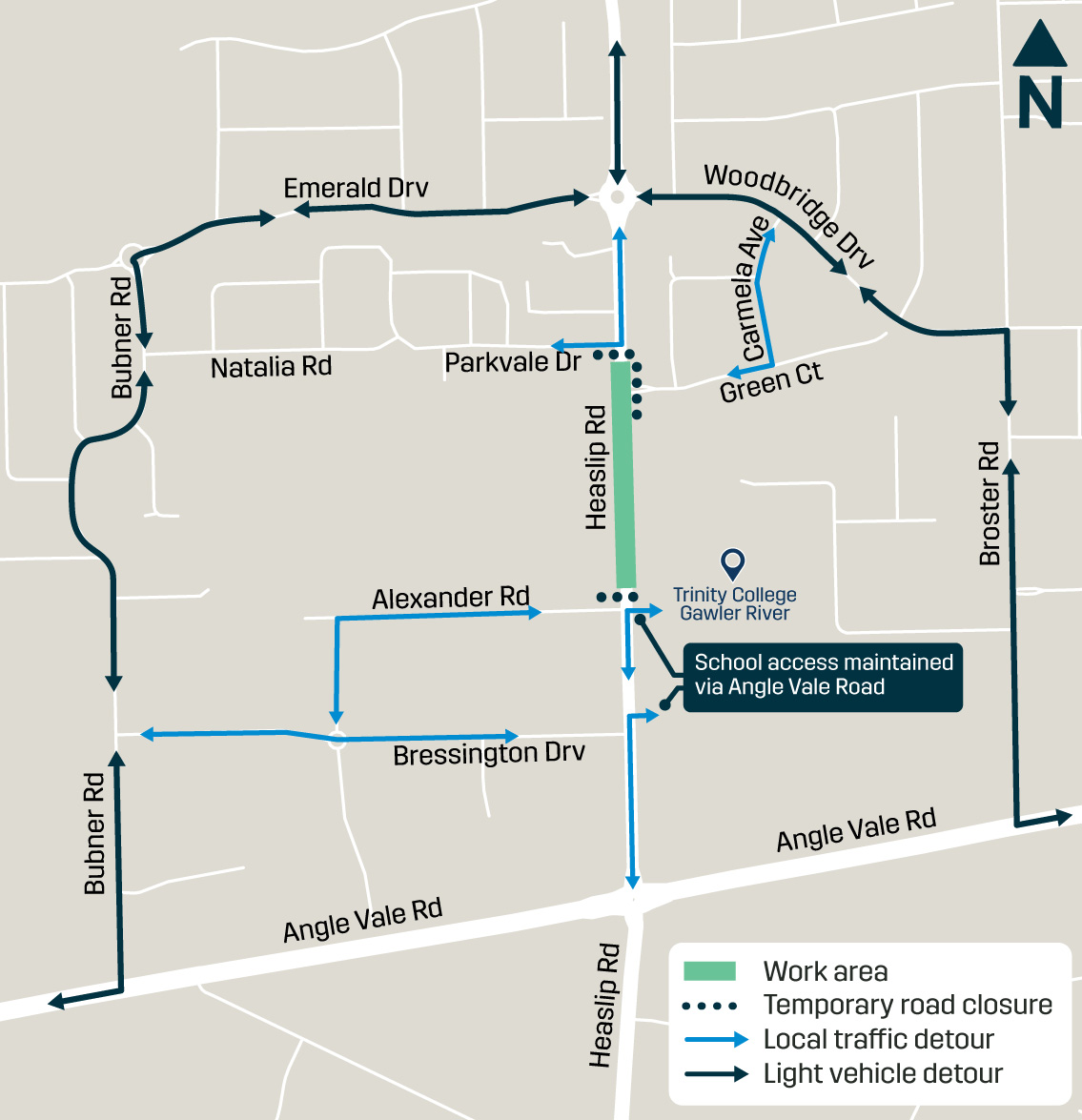

Where: Heaslip Road, between Angle Vale Road roundabout and Parkvale Drive, Angle Vale
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:
- works in front of Trinity College are expected to occur during school holidays

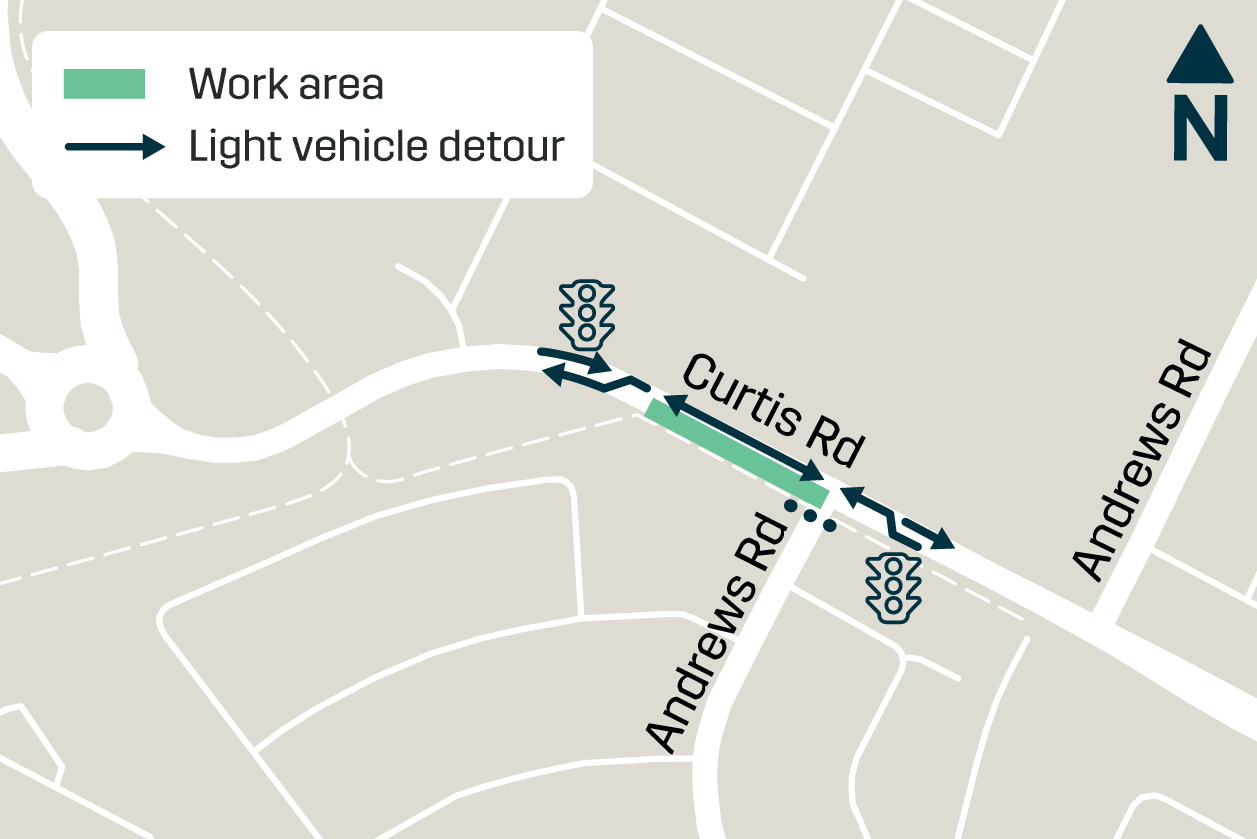

- Heaslip Road will be closed to traffic between Alexander Road and the Emerald Drive / Woodbridge Drive roundabout, day and night for the duration of the works
- where possible, Heaslip Road we will be opened to traffic overnight
- detours will be in place, please follow signage onsite
- changed traffic conditions will apply
- some vibration, noise and dust are to be expected during these works
- local, school and business access will be maintained at all times.

Please note, traffic arrangements may change depending on site conditions.
Thank you for your patience while we complete these essential works.

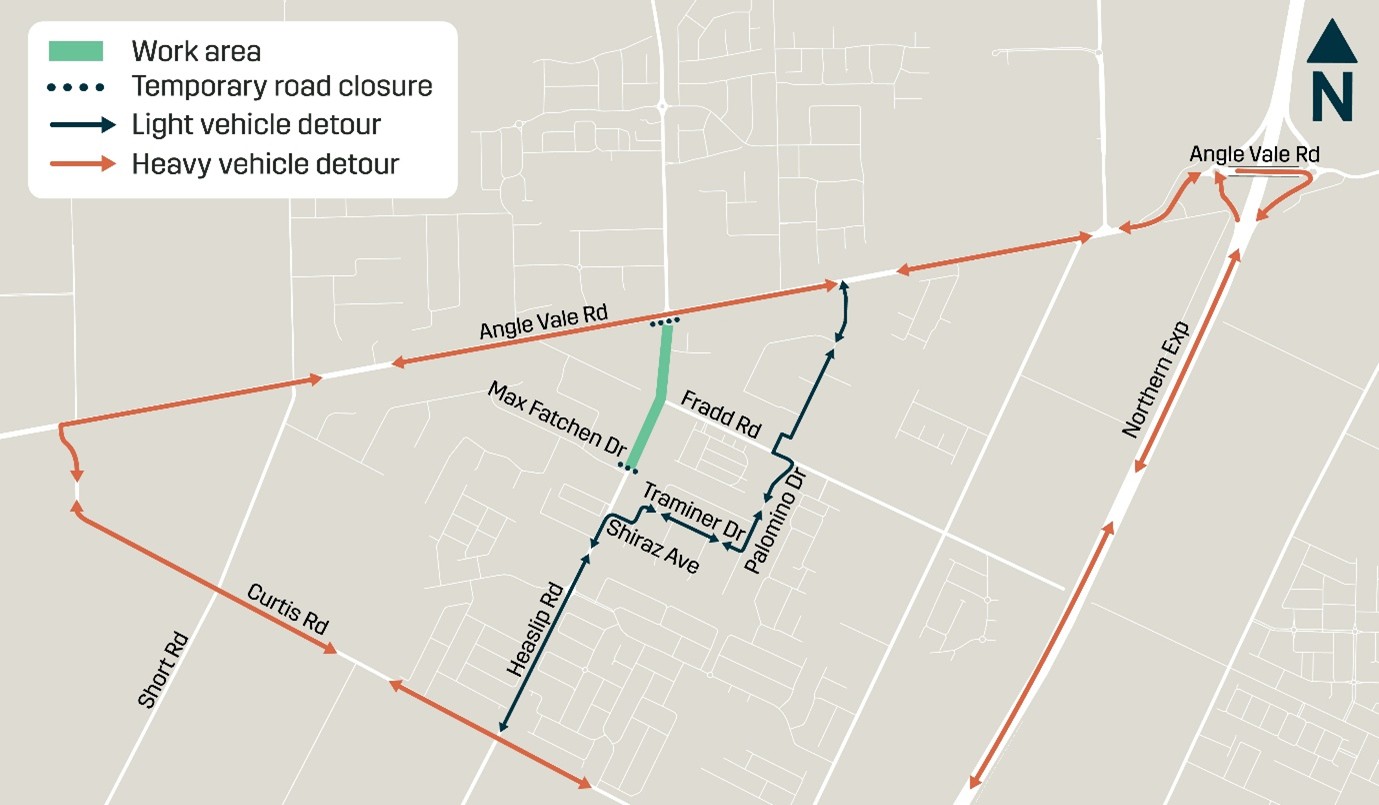

When: 14 September until late 2026
Where: Heaslip Road, between Angle Vale Road roundabout and Parkvale Drive, Angle Vale
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:
- works in front of Trinity College are expected to occur during school holidays
- Heaslip Road will be closed to traffic between Alexander Road and the Emerald Drive / Woodbridge Drive roundabout, day and night for the duration of the works
- where possible, Heaslip Road we will be opened to traffic overnight
- detours will be in place, please follow signage onsite
- changed traffic conditions will apply
- some vibration, noise and dust are to be expected during these works
- local, school and business access will be maintained at all times.

Please note, traffic arrangements may change depending on site conditions.
Thank you for your patience while we complete these essential works.
-

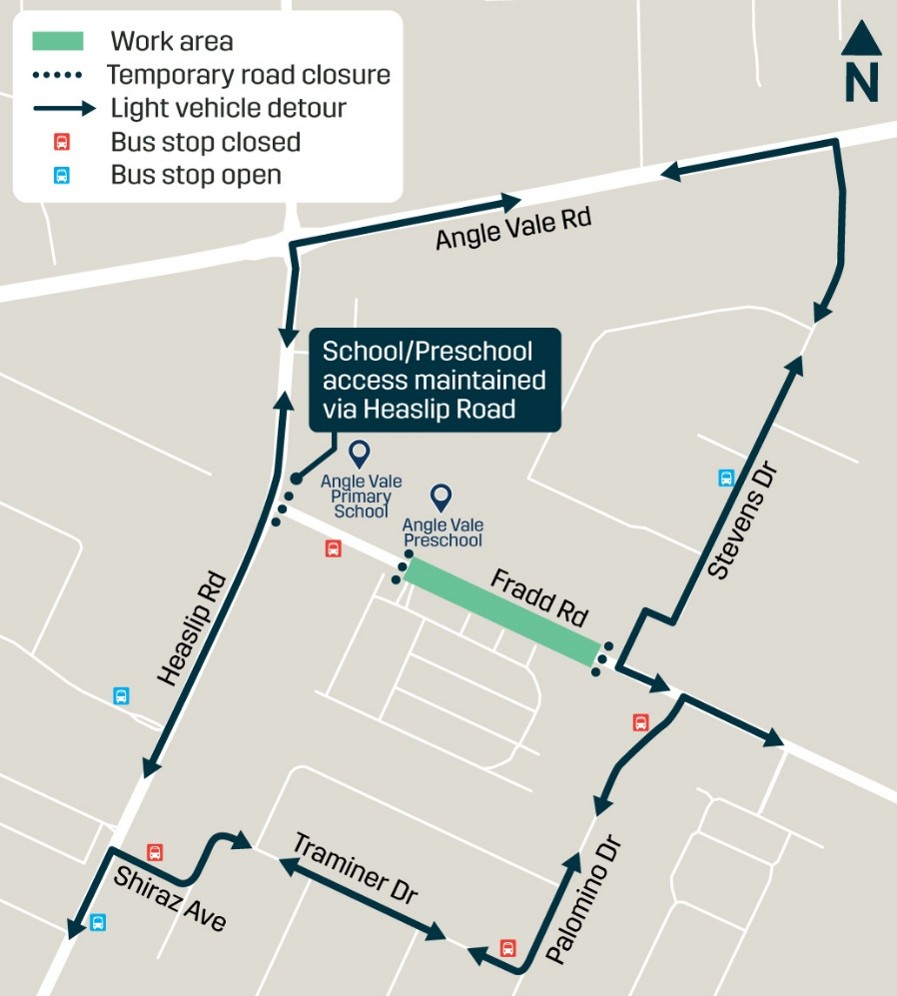

Road closure – Fradd Road, between Heaslip Road and Matthew Road, Angle Vale
Share Road closure – Fradd Road, between Heaslip Road and Matthew Road, Angle Vale on Facebook Share Road closure – Fradd Road, between Heaslip Road and Matthew Road, Angle Vale on X (formerly Twitter) Share Road closure – Fradd Road, between Heaslip Road and Matthew Road, Angle Vale on Linkedin Email Road closure – Fradd Road, between Heaslip Road and Matthew Road, Angle Vale linkWhere: Fradd Road, between Heaslip Road and Matthew Road, Angle Vale
When: August to late-2026
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:

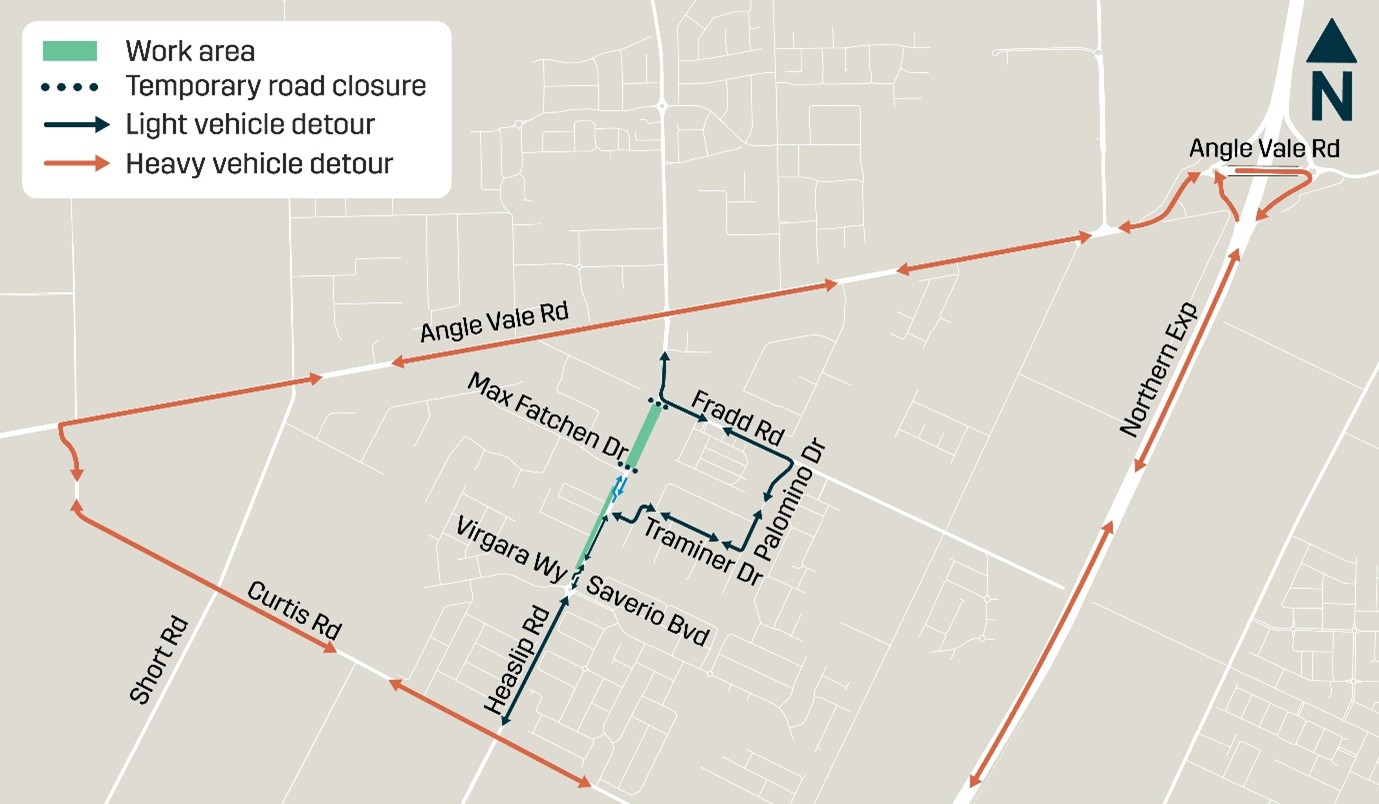

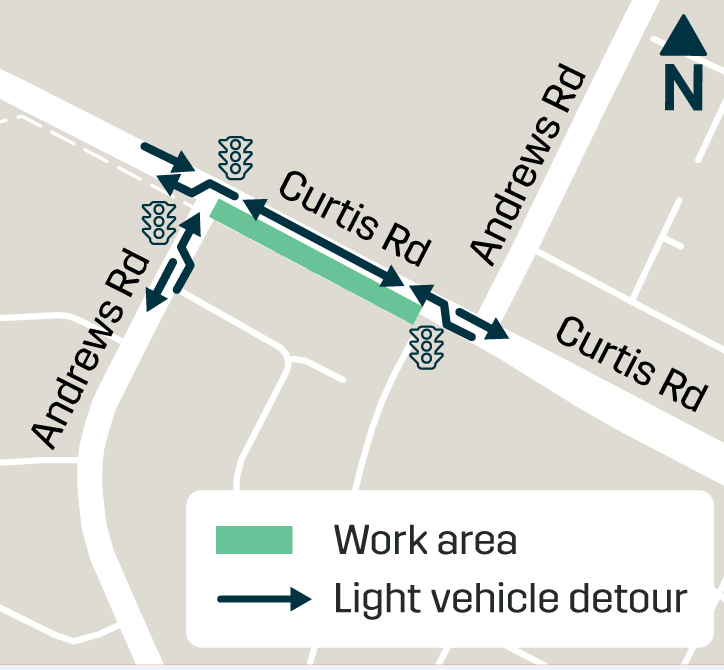

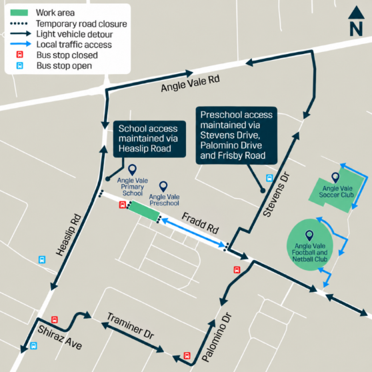

the work zone on Fradd Road, between Heaslip Road and the western driveway of the Angle Vale Gardens Retirement Estate will be closed to traffic during the works
works and closures will move progressively
detours will be in place, please follow signage onsite
some vibration, noise and dust are to be expected during these works
local and business access will be maintained at all times.
Detour 7:00 am – 5:00 pm, Monday to Friday
Local access will be maintained via:
Heaslip Road for Angle Vale Primary School and properties west of the Angle Vale Gardens Retirement Estate.
Stevens Drive, Palomino Drive and Frisby Road for Angle Vale Preschool, the Angle Vale Gardens Retirement Estate and properties east of the retirement estate

Please note, traffic arrangements may change depending on site conditions.
We will restore any impacted roads, footpaths or the environment as soon as it’s safe and practical to do so.
Thank you for your patience while we complete these essential works.
Where: Fradd Road, between Heaslip Road and Matthew Road, Angle Vale
When: August to late-2026
Hours of work: 7:00 am – 5:00 pm, Monday to Friday
Key details:
the work zone on Fradd Road, between Heaslip Road and the western driveway of the Angle Vale Gardens Retirement Estate will be closed to traffic during the works
works and closures will move progressively
detours will be in place, please follow signage onsite
some vibration, noise and dust are to be expected during these works
local and business access will be maintained at all times.
Detour 7:00 am – 5:00 pm, Monday to Friday
Local access will be maintained via:
Heaslip Road for Angle Vale Primary School and properties west of the Angle Vale Gardens Retirement Estate.
Stevens Drive, Palomino Drive and Frisby Road for Angle Vale Preschool, the Angle Vale Gardens Retirement Estate and properties east of the retirement estate

Please note, traffic arrangements may change depending on site conditions.
We will restore any impacted roads, footpaths or the environment as soon as it’s safe and practical to do so.
Thank you for your patience while we complete these essential works.
-
Project update - Curtis and Heaslip Road
Share Project update - Curtis and Heaslip Road on Facebook Share Project update - Curtis and Heaslip Road on X (formerly Twitter) Share Project update - Curtis and Heaslip Road on Linkedin Email Project update - Curtis and Heaslip Road linkNew water and wastewater pipes installed beneath Curtis Road and Heaslip Road are on schedule and continuing to progress at pace.
Heaslip Road update
In July the new water pipes under Heaslip Road were turned on and are now servicing the local area. Wastewater pipes are continuing to be laid beneath Heaslip Road until the end of 2026.
Heaslip Road has been temporarily reinstated during our works. The permanent reinstatement of Heaslip Road, between Alicante Court and Plati Road, is scheduled for late-August. Permanent reinstatement for the rest of Heaslip Road will occur once works are completed. For the section of Heaslip Road, where water and wastewater pipes are installed close together, we will reinstate the full lane to ensure a smooth and consistent driving surface for commuters.
Curtis Road reinstatement
Wastewater pipe installation along Curtis Road between the Northern Expressway and Andrews Road has been completed, and permanent road reinstatement is complete. Further wastewater pipe installation west of the Northern Expressway is due to commence in late-2026.
About temporary and permanent reinstatement work
As a standard practice, we temporarily reinstate areas, such as roads and footpaths at the end of each shift to ensure the area is safe and accessible for commuters. This approach allows us to reopen the road for commuters as quickly as possible between shifts to minimise disruption while also enabling us to return to the same area if needed should any issues arise during pipe laying, testing or commissioning prior to permanent reinstatement.
Once pipes are installed and operational, we return to permanently reinstate areas affected by our works.
Final road reinstatement occurs at the completion of key sections of pipe installations and testing.
Find out more about reinstatement here
We appreciate the community’s patience while we deliver this critical infrastructure to support housing growth across Adelaide’s north.

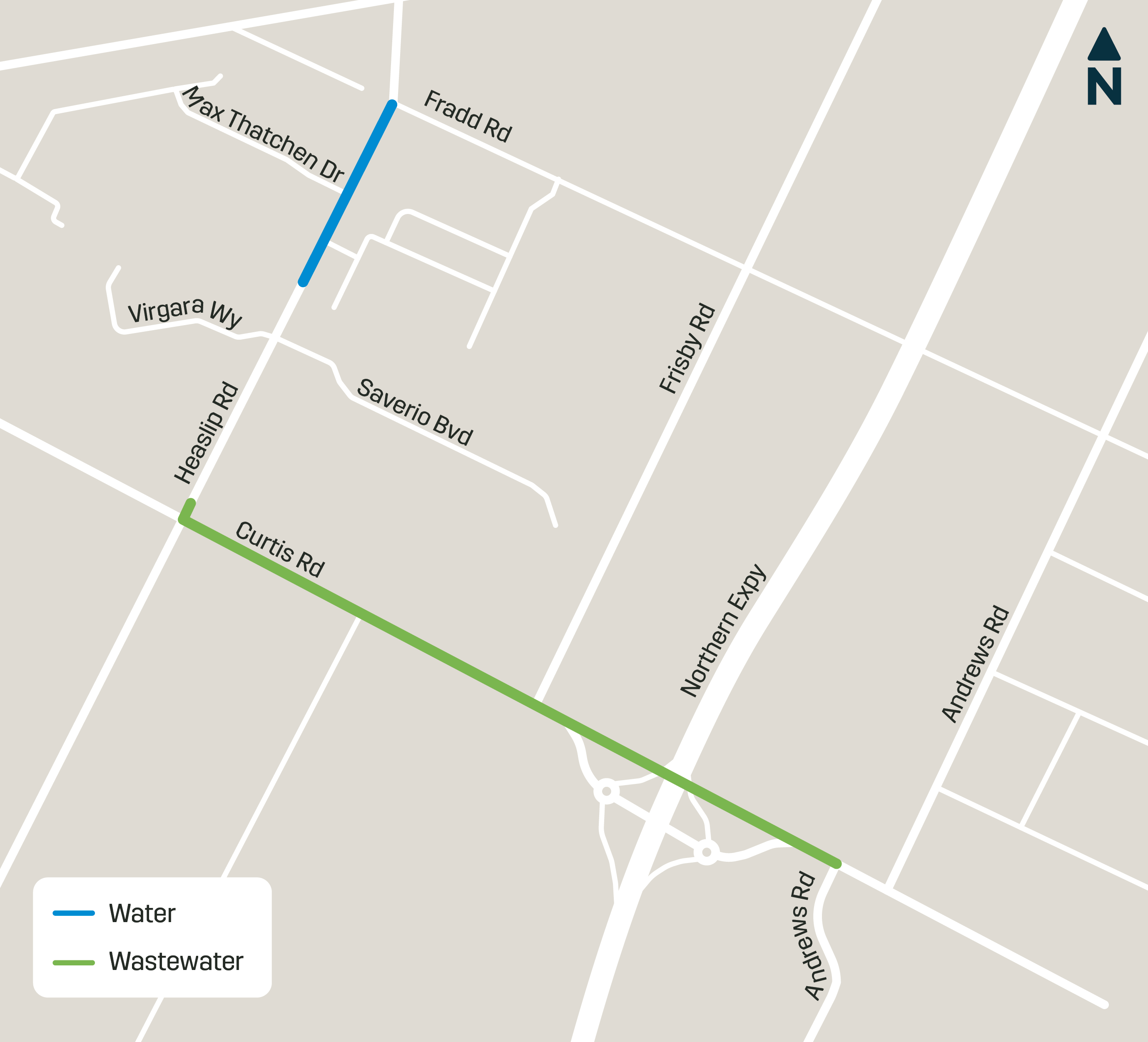

New water and wastewater pipes installed beneath Curtis Road and Heaslip Road are on schedule and continuing to progress at pace.
Heaslip Road update
In July the new water pipes under Heaslip Road were turned on and are now servicing the local area. Wastewater pipes are continuing to be laid beneath Heaslip Road until the end of 2026.
Heaslip Road has been temporarily reinstated during our works. The permanent reinstatement of Heaslip Road, between Alicante Court and Plati Road, is scheduled for late-August. Permanent reinstatement for the rest of Heaslip Road will occur once works are completed. For the section of Heaslip Road, where water and wastewater pipes are installed close together, we will reinstate the full lane to ensure a smooth and consistent driving surface for commuters.
Curtis Road reinstatement
Wastewater pipe installation along Curtis Road between the Northern Expressway and Andrews Road has been completed, and permanent road reinstatement is complete. Further wastewater pipe installation west of the Northern Expressway is due to commence in late-2026.
About temporary and permanent reinstatement work
As a standard practice, we temporarily reinstate areas, such as roads and footpaths at the end of each shift to ensure the area is safe and accessible for commuters. This approach allows us to reopen the road for commuters as quickly as possible between shifts to minimise disruption while also enabling us to return to the same area if needed should any issues arise during pipe laying, testing or commissioning prior to permanent reinstatement.
Once pipes are installed and operational, we return to permanently reinstate areas affected by our works.
Final road reinstatement occurs at the completion of key sections of pipe installations and testing.
Find out more about reinstatement here
We appreciate the community’s patience while we deliver this critical infrastructure to support housing growth across Adelaide’s north.
-
Stay informed and have your say
Share Stay informed and have your say on Facebook Share Stay informed and have your say on X (formerly Twitter) Share Stay informed and have your say on Linkedin Email Stay informed and have your say linkAs we upgrade our water and wastewater networks, we’d love to hear from you. Your feedback helps us understand what’s working well and where we can improve. Visit this link to have your say.
Read our Community Newsletter for updates on works happening near you, how we’re working to minimise disruptions, and ways to stay informed.
As we upgrade our water and wastewater networks, we’d love to hear from you. Your feedback helps us understand what’s working well and where we can improve. Visit this link to have your say.
Read our Community Newsletter for updates on works happening near you, how we’re working to minimise disruptions, and ways to stay informed.
-
January 2026
Angle Vale to Munno Para West: Curtis Road, Heaslip Road has finished this stageHeaslip Road (Angle Vale) pump station works begin.
-
January to late-February 2026
Angle Vale to Munno Para West: Curtis Road, Heaslip Road has finished this stageNight works - Curtis Road/Heaslip Road intersection
Water and wastewater pipeline upgrades at the corner of Heaslip Road and Curtis Road.
-
Mid-March to end-May 2026
Angle Vale to Munno Para West: Curtis Road, Heaslip Road has finished this stageNight works
Curtis Road, Munno Para West - Wastewater pipeline installation from Andrews Road to Northern Expressway.
Curtis Road, Angle Vale - Wastewater pipeline installation from Northern Expressway to Heaslip Road.

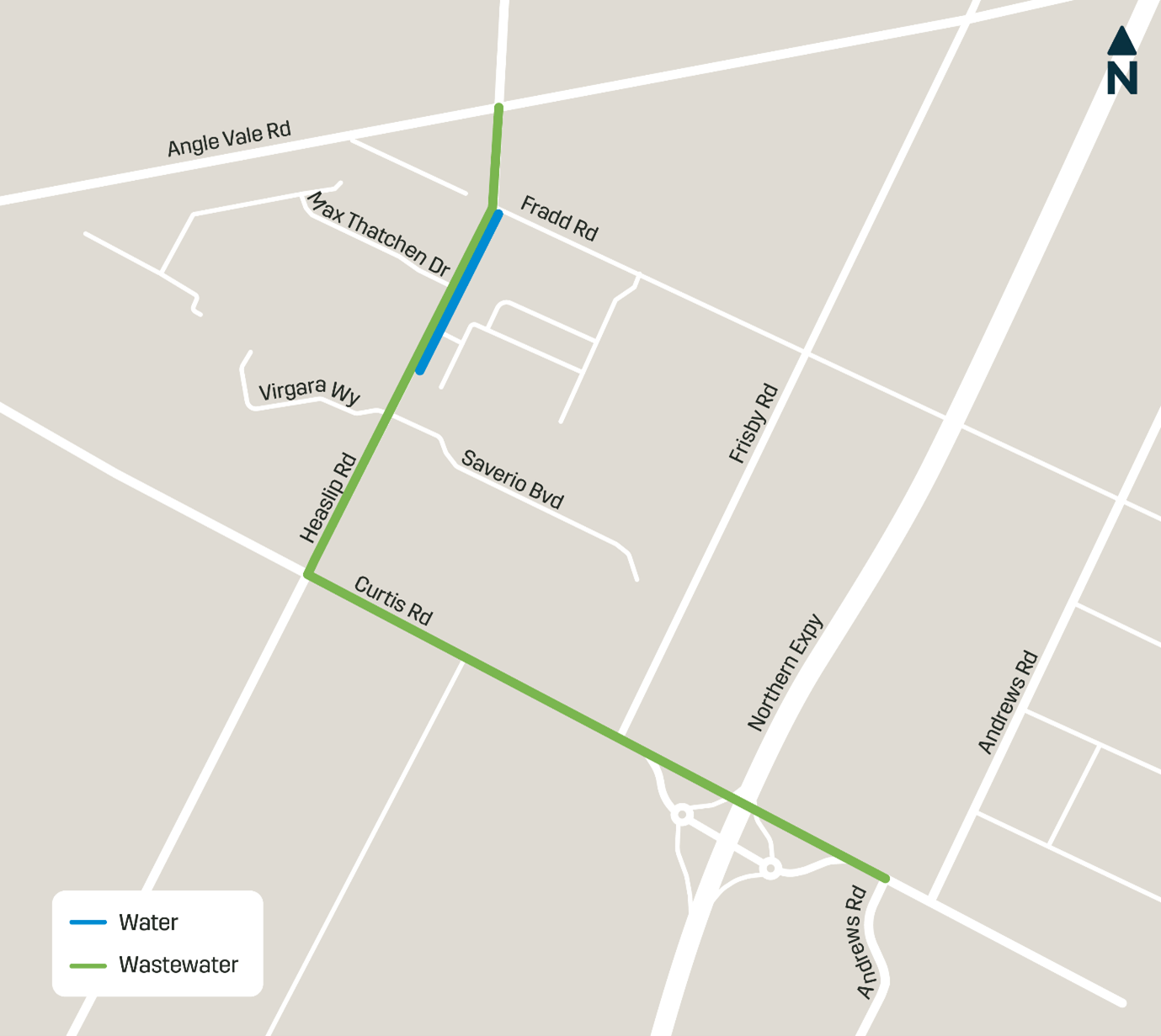

Heaslip Road, Angle Vale - Wastewater pipeline installation between Curtis Road and Virgara Way.
Multiple work crews will be mobilised along the alignment.
-
Early-June 2026

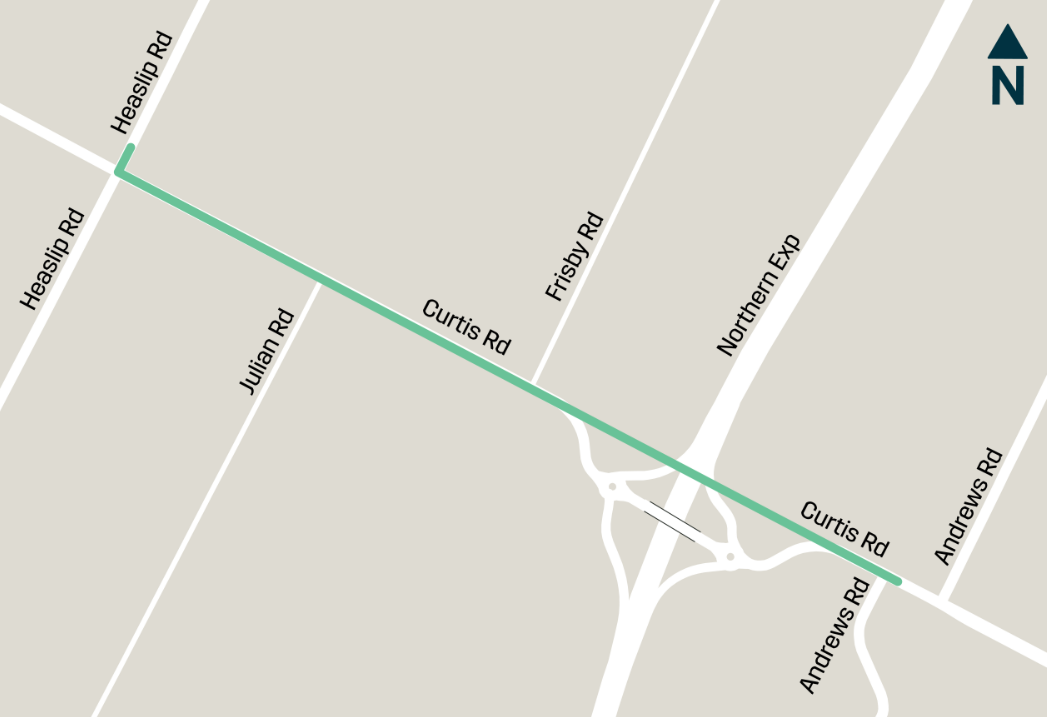

Angle Vale to Munno Para West: Curtis Road, Heaslip Road has finished this stageCurtis Road works completed.
-
June 2026 to Mid-2027
Angle Vale to Munno Para West: Curtis Road, Heaslip Road is currently at this stageAngle Vale to Munno Para West: Curtis Road, Heaslip Road is currently at this stage
Ongoing works for Angle Vale to Munno Para West: Curtis Road, Heaslip Road
Night works
Water and wastewater pipe installation and associated works along Heaslip Road from Curtis Road. Works will move progressively along Heaslip Road with completion expected mid-2027.
Multiple work crews will be mobilised along the alignment.
Day works
Wastewater pipe installation along Ashwin Street, Luis Drive, Angle Vale with completion expected late-August 2026. -
June to August 2026
this is an upcoming stage for Angle Vale to Munno Para West: Curtis Road, Heaslip RoadWastewater pipe installation along Brookes Street, Felicity Road, Macon Road, Audrey Avenue, Dijon Road and Casetta Crescent, Angle Vale
-
July 2026 to early-2027
this is an upcoming stage for Angle Vale to Munno Para West: Curtis Road, Heaslip RoadWastewater pipe installation along Fradd Road, Angle Vale.
-
Mid-2027 – project completion
this is an upcoming stage for Angle Vale to Munno Para West: Curtis Road, Heaslip RoadHeaslip Road works completed.
-
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Phone 1300 981 233 Email metrogrowth@sawater.com.au -
Phone 1300 981 233 Email metrogrowth@sawater.com.au
-
Metro Growth Community Newsletter August 2026 (2.64 MB) (pdf)
-
Metro Growth Community Newsletter June 2026 (1.16 MB) (pdf)
-
Metro Growth Community Newsletter April 2026 (1.11 MB) (pdf)
-
Metro Growth Community Newsletter February 2026 .pdf (2.4 MB) (pdf)
-
Metro Growth Community Newsletter December 2025.pdf (1.44 MB) (pdf)
-
Metro Growth Community Newsletter October 2025 (1.81 MB) (pdf)
-
Metro Growth Community Newsletter August 2025 .pdf (5 MB) (pdf)
-
Metro Growth Community Newsletter June 2025.pdf (2.36 MB) (pdf)
-
Metro Growth Community Newsletter May 2025 (2.01 MB) (pdf)
-
Metro Growth Community Newsletter April 2025 (2.01 MB) (pdf)
-
Metro Growth Community Newsletter March 2025 (1.41 MB) (pdf)
Deaf, hearing or speech impaired customers.
Contact us through the National Relay Service and ask for SA Water on 1300 981 233.
- TTY users phone 133 677 then ask for SA Water on 1300 981 233
- Speak and Listen users phone 1300 555 727 then ask for SA Water on 1300 981 233

Calling from overseas
You can contact us on +61 8 7424 1735
